Introduction
Installing an access control system in a commercial or public-sector building looks simple from the outside. A reader, a lock, a badge, done.
In practice, a single opening can involve door hardware, low-voltage wiring, power distribution, network infrastructure, software configuration, and life-safety code compliance.
Many facility teams underestimate that complexity. They treat access control as a plug-and-play upgrade, and that's when problems surface:
- Doors that won't unlock
- Credentials that never register
- Gaps in the audit trail
- Egress paths that quietly violate fire code
Trained security integrators, licensed electricians, low-voltage technicians, and IT staff often need to coordinate on a single door opening. Complex, multi-door, or regulated projects should never be treated as a weekend DIY task.
This guide covers planning, components, installation steps, testing, troubleshooting, documentation, and when to bring in a professional integrator.
Key Takeaways
- Coordinate doors, locks, controllers, power, network, credentials, software, and emergency operation up front to avoid rework.
- Door type, infrastructure, opening count, integrations, and compliance requirements set project cost and timeline.
- Test every opening for grant/deny, safe egress, door status, power-loss behavior, alarms, and reporting.
- Commissioning docs, admin training, and ongoing support keep systems reliable after go-live.
Installation Guide for an Access Control System
A commercial access control project generally follows the same sequence regardless of size: assessment and design, equipment selection, infrastructure preparation, hardware installation, software configuration, integration, then testing and handoff.
What changes is the scale. A single interior office door might take a day. A multi-door commercial facility can run weeks. A distributed multi-site deployment can take months and needs phased rollout planning.
Every installation, no matter the size, rests on four functional building blocks connected through power, wiring, and network infrastructure:
- Credential reader at the door
- Access control panel or controller that makes the access decision
- Electronic locking hardware that secures the opening
- Management software that governs permissions, schedules, and records
Prerequisites and Safety Considerations
Before any hardware goes on a door, the project team needs answers to a specific set of questions. Skipping this step is the single biggest cause of expensive rework later.
Site survey. Document, for every opening:
- Door and frame condition, swing direction, and existing lock type
- Controlled areas and available cable pathways
- Equipment locations, available power, and network access
- Environmental exposure, including exterior doors and temperature extremes
Compatibility check. Confirm that readers, credentials, controllers, electronic locks, power supplies, and software work together, and that planned integrations with fire alarm panels, video systems, elevators, or gates are actually supported by the manufacturers involved.

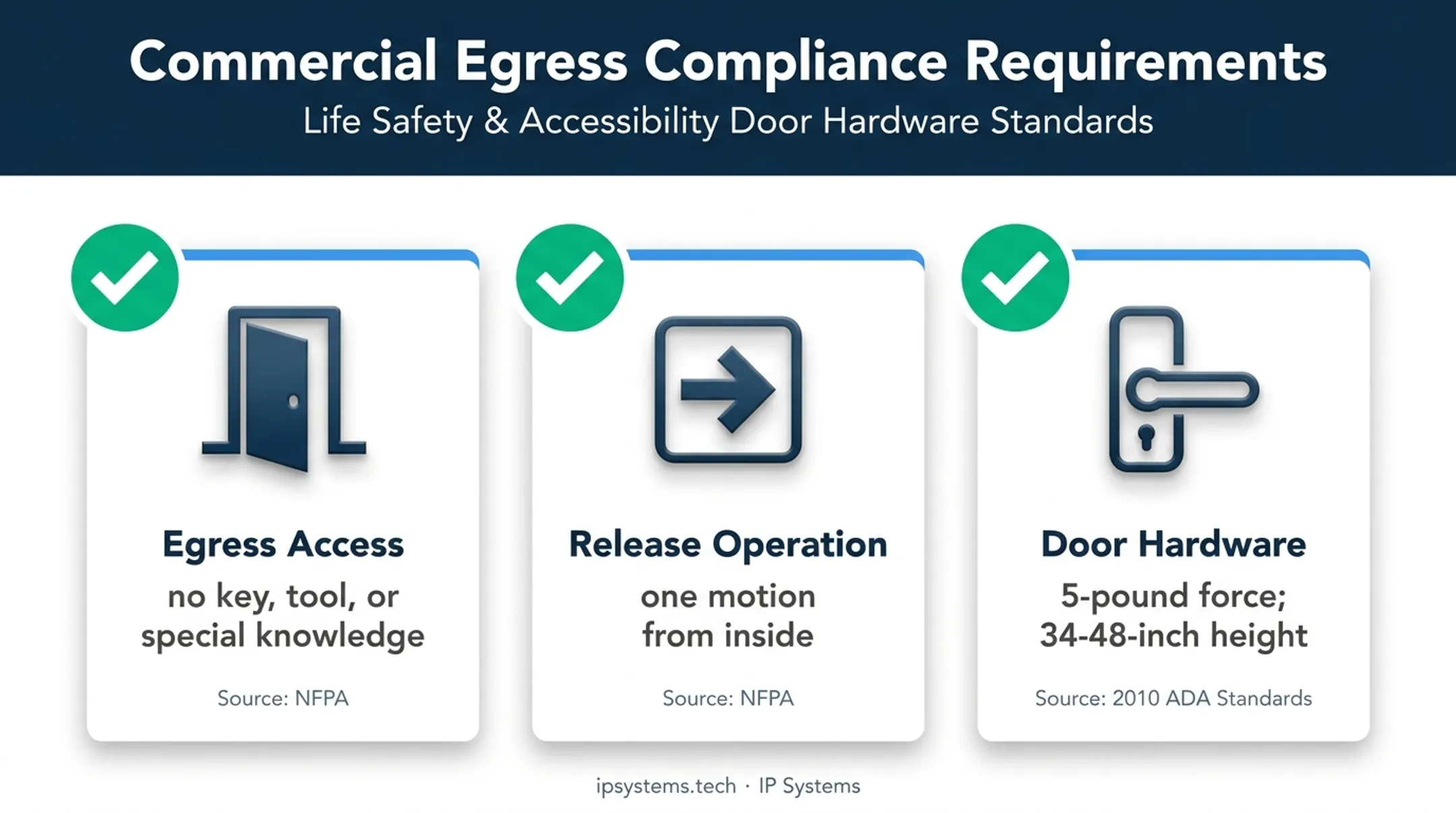

Code review. Life-safety and accessibility requirements aren't optional extras layered on at the end. Egress doors generally can't require a key, tool, or special knowledge to open from the inside, and release must happen in one motion, according to NFPA. The 2010 ADA Standards also cap door hardware activation force at 5 pounds and set mounting height between 34 and 48 inches.
Research the building, fire, electrical, and accessibility codes that apply in your jurisdiction and sector before finalizing a design.

Non-negotiables. Do not proceed if you find:
- Damaged or incompatible doors and frames
- Unresolved egress concerns
- Inadequate power or missing network infrastructure
- Unsafe work conditions
- Unapproved changes to fire or life-safety systems
Tools and Parts Required
Think of this as a checklist, not a wiring manual. Exact specifications depend on your approved design.
Typical components:
- Readers, controllers, and electronic strikes or magnetic locks
- Door position sensors and request-to-exit devices
- Power supplies and backup power
- Cabling, enclosures, credentials, and management software
Typical tools (used by qualified personnel):
- Mounting and drilling tools
- Cable-routing and termination tools
- Labeling supplies
- Network-testing equipment
- Electrical test equipment
Exact cable types, wire gauges, power ratings, connectors, and mounting hardware must follow manufacturer documentation and the approved system design.
A wood interior door with a magnetic lock has different power and mounting needs than a fire-rated exterior door with an electric strike. There's no universal spec sheet that covers both.
How to Install an Access Control System (Step-by-Step)

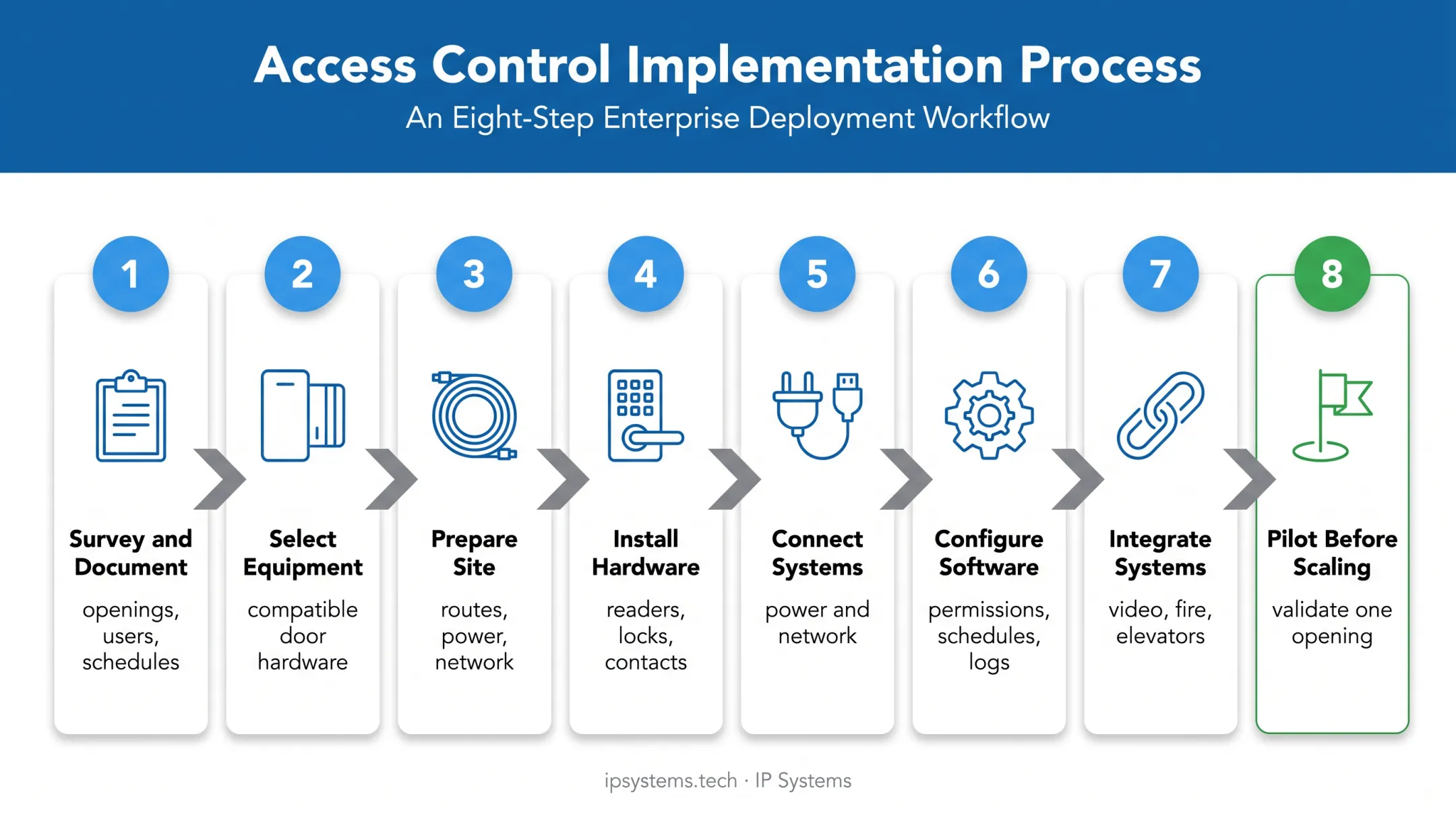

This is a controlled sequence. Shortcuts here tend to surface as failures weeks after the system is live, not during installation itself.
- Survey and document every controlled opening, user group, access schedule, security objective, and integration need.
- Select compatible equipment—readers, credentials, controllers, locks, power, and software—based on actual door conditions.
- Prepare the site: confirm cable routes, controller locations, power, network ports, permits, and occupant notifications.
- Install and secure hardware, readers, locks, controllers, door contacts, and request-to-exit devices, per approved drawings and manufacturer instructions.
- Connect power and network, following electrical safety procedures and protecting cables as required by the design.
- Configure software: doors, credentials, role-based permissions, schedules, alerts, audit logs, and admin accounts.
- Integrate related systems (video, fire alarm, intercoms, gates, elevators, or visitor management) only after confirming compatibility.
- Pilot before scaling. Validate one representative opening before repeating the design across a multi-door or multi-site deployment.

IP Systems staffs this sequence with project managers, installation technicians, and software specialists working from initial assessment through client sign-off and administrator training.
Post-Installation Checks and Validation
Installation isn't finished until the system has been commissioned, documented, and formally accepted by the responsible facility or security team.
- Visual and structural checks: readers, locks, controllers, wiring, and exit devices are secure, labeled, and undamaged.
- Credential testing across user groups, schedules, doors, and access methods—confirm permissions and denials log correctly.
- Event testing for door-held alerts, request-to-exit behavior, alarms, monitoring notifications, and audit logs.
- Life-safety validation: emergency egress, fire-alarm response, power-loss behavior, backup power, and accessibility—verified with qualified parties.
- Handoff package: as-builts, door schedules, configuration details, admin instructions, warranties, and open items.
Skipping commissioning doesn't save time. Locked-out users, bad access records, and unsafe exit conditions usually appear only after people already depend on the system every day. Formal acceptance catches those gaps before handoff.

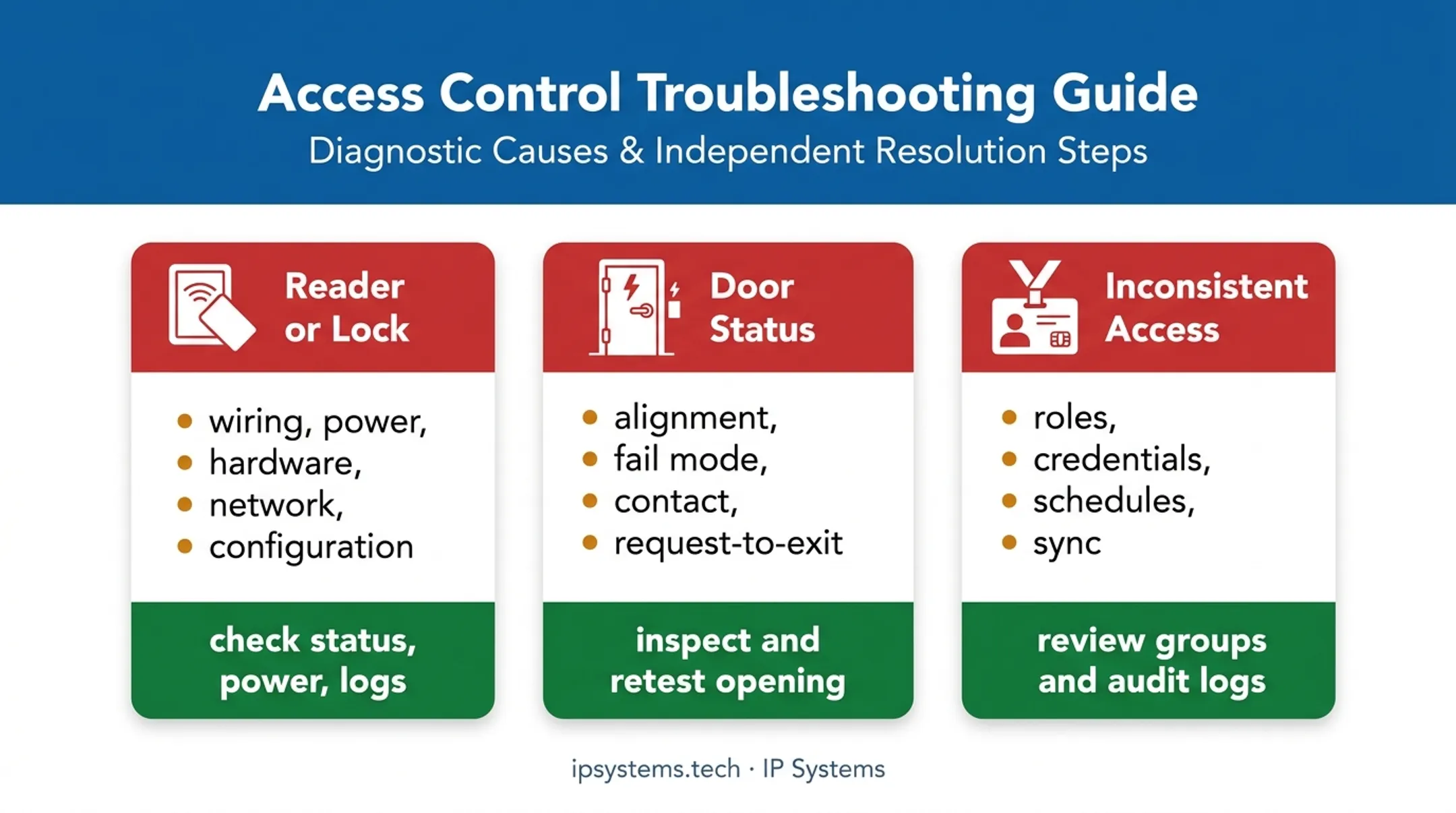

Common Installation Problems and Fixes
These issues typically appear during installation, commissioning, or the first weeks of operation. Only personnel with the right electrical or systems training should diagnose them.
Issue 1: Reader or lock does not respond
A credential is presented but nothing happens, or the reader shows no activity at all. Likely causes include:
- Incorrect wiring
- Interrupted power
- Incompatible hardware
- Network communication failure
- Controller configuration error
Fix: Check device status, power and communication indicators, configuration settings, and event logs against approved documentation. Have qualified personnel correct any wiring or power issues.
Issue 2: Door remains unlocked, fails to release, or reports the wrong status
The lock's behavior doesn't match the approved design, or the software shows the door as open when it's closed (or vice versa). Common causes:
- Misaligned lock hardware
- Incorrect fail-safe or fail-secure configuration
- A defective door contact
- Improper request-to-exit setup
- A mismatch between the physical door and its software settings
Fix: Inspect mechanical alignment and configuration, verify the approved life-safety behavior, and retest the whole opening. Don't change one setting in isolation and assume it's fixed.
Issue 3: Users receive inconsistent access
Some employees get into doors or schedules they shouldn't, while others with valid credentials get denied. Usual culprits include:
- Incorrect role assignments
- Expired or duplicate credentials
- Schedule conflicts
- Sync delays between sites
- Configuration drift across locations
Fix: Review user groups, schedules, credential status, and audit logs. Check synchronization health across controllers and sites, and put a documented provisioning and revocation process in place so this doesn't repeat.

If problems continue after these checks, IP Systems' Service & Repair Calls team can troubleshoot issues like intermittent door readers during standard business hours.
Pro Tips for Installing an Access Control System Effectively
- Sequence the work with every stakeholder. Construction, door hardware, electrical, network, fire, security, and IT all touch the same openings—late changes force expensive rework.
- Survey before you spec equipment. Prioritize this on retrofits in occupied buildings, older facilities, exterior openings, and large campuses.
- Standardize naming, labeling, and permission structures. Consistent schemes across doors and sites simplify audits, troubleshooting, and expansion.
- Build in cybersecurity from day one. Connected access devices are part of the network attack surface. Follow CISA's guidance on physical and cyber convergence on patching, limited internet exposure, VPNs, segmentation, monitoring, and least-privilege admin accounts.
- Schedule preventive maintenance for readers, locks, power supplies, network gear, software, backup power, and door contacts on the manufacturer's recommended interval.
- Bring in a qualified integrator for multi-door work, regulated sites, fire-alarm coordination, elevator or gate integration, video tie-ins, or multi-site management.
For assessment, design, installation, integration, monitoring, or ongoing support, IP Systems is a security systems integrator serving commercial and public-sector environments.
Access control deployments range from single-door applications to enterprise systems managing thousands of doors and alarm points, backed by Network Operations Center support, device-health monitoring, and predictive maintenance.
Conclusion
Installation quality determines whether an access control system stays reliable for ten years or generates support tickets in month three. It shapes emergency operation, audit accuracy, and cybersecurity exposure. It also decides how easily the system scales—and how long the hardware lasts.
Before go-live, lock in these fundamentals:
- Document the site assessment
- Choose compatible components
- Coordinate electricians, IT, and the fire marshal
- Follow codes for your building and sector
- Validate every door functionally before anyone relies on the system
If your organization is planning a new installation or needs a second look at an existing one, contact IP Systems at (330) 963-0064 or salesteam@ipsystems.tech to schedule an access control assessment or installation review.
