Add contractors rotating through, visitors checking in at the front desk, tenants sharing a building, and restricted rooms only some staff should enter, and the gaps widen. A lost key means rekeying. A terminated employee means hoping someone remembers to collect the badge.
The research backs this up. In ASIS International's 2023 access control research, the most common failures reported for the prior six months were tailgating or piggybacking (61% of organizations), propped doors (50%), and card or credential sharing (38%).
These failures often hide in plain sight. In Mastering Modern Security, IPS's Rob Jackson describes a plant where an exterior gate reader had been broken for six months and visitors piggybacked through every day, because the system "still works most of the time."
This guide covers commercial physical access control: the systems that manage entry to buildings, doors, gates, elevators, and secured areas. It doesn't cover logical access to networks or software. We'll cover how these systems work, which components matter, how to choose one, and how to keep it running after installation, including the mistakes we see most often.
Key Takeaways
- Credentials, readers, controllers, locking hardware, software, and policy secure a building only when they work as one system
- Match the platform to building layout, user groups, risk, and growth plans, not a generic feature list
- Installation is step one; permission reviews, firmware updates, and maintenance decide long-term security
- Choose cloud, on-premises, or hybrid based on your IT structure and number of sites
What Is Commercial Building Access Control and How Does It Work?
Commercial access control is a physical security system that authenticates a person or credential, checks whether that person is authorized for a specific door or area, releases the lock if approved, and logs the event.
The National Institute of Standards and Technology defines a physical access control system as an electronic system that controls the ability of people or vehicles to enter a protected area through authentication and authorization at access control points. Those two words, authentication and authorization, aren't interchangeable, even though people often use them that way.
Authentication vs. Authorization
Authentication confirms who someone is. Authorization decides where they're allowed to go.
That split runs through the federal Interagency Security Committee's facility access control guidance, published through the Cybersecurity and Infrastructure Security Agency.
Take an employee badging into the main lobby at 8 a.m. The system authenticates the credential, confirms it's valid, and releases the door.
The same employee then walks up to the server room. Authentication succeeds again, but authorization fails. They're not on the list for that space, so the door stays locked.
The Access Event, Step by Step

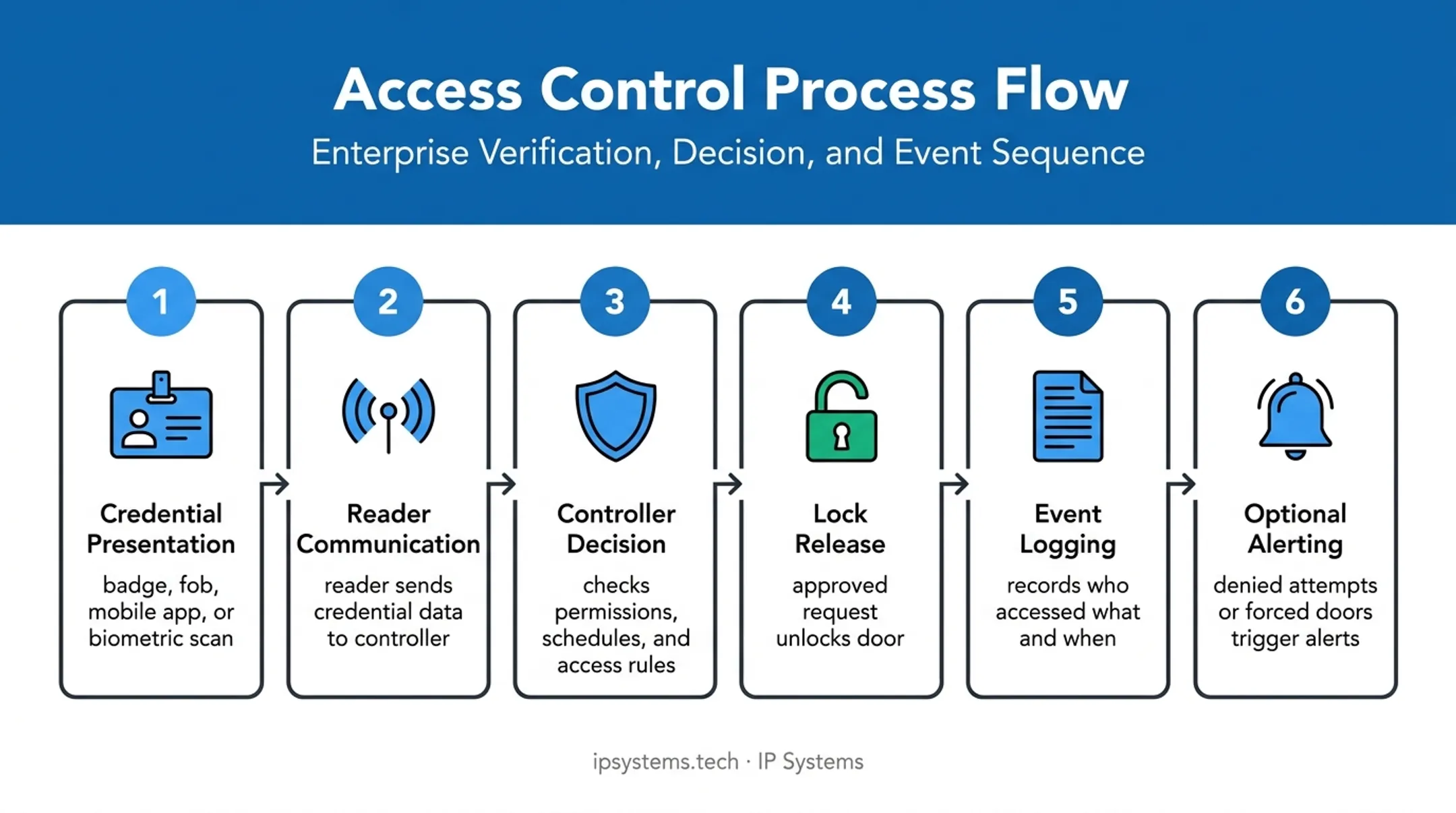

Every access attempt follows roughly the same sequence:
- Credential presentation: a badge, fob, mobile credential, or biometric is presented to a reader
- Reader communication: the reader sends the credential data to a controller
- Controller decision: the controller checks permissions, schedules, and access rules
- Lock release: an approved request releases the door for a set time
- Event logging: the system records who accessed what, and when
- Optional alerting: denied attempts or forced doors can trigger alerts or pull linked video

Different user groups need different rules:
- Employees may get round-the-clock access to common areas but restricted hours elsewhere
- Contractors often get temporary credentials tied to a project timeline
- Visitors usually need escorted or single-use access
- Emergency responders need a way in regardless of schedules
Design for power and network failures before install day. A fail-safe lock releases when power drops; a fail-secure lock stays locked. Whatever the lock, egress doors must still open from the inside without a key or special knowledge, which is why electrified locks on egress paths are often fail-safe or paired with mechanical free egress. Confirm each door with the fire marshal or AHJ before hardware is ordered. Getting this wrong is one of the few access control mistakes that can fail an inspection or put people at risk.
Components and Types of Commercial Access Control Systems
A commercial access control system is a stack of parts that depend on each other. Miss one and the rest won't work properly.
Core Components
- Readers: accept cards, fobs, mobile credentials, PINs, or biometrics at each door
- Controllers: make permission decisions and talk to readers, locks, alarms, and software
- Locking hardware: electric strikes, maglocks, exit devices, request-to-exit sensors, and door-position contacts that secure each opening and report its status
- Management software: users, access levels, schedules, event logs, alerts, and reports
- Network and power infrastructure: wiring, network connections, power supplies, and backup power
Ask how readers connect to controllers. OSDP (Open Supervised Device Protocol) supports encrypted, two-way, supervised communication. Legacy Wiegand is one-way and unencrypted. If you're reusing existing readers and wiring, find out which you have and whether it's worth changing now or at the next phase.
Comparing Credential Types
Not every credential fits every use. Here's how the common options compare:
| Credential | Best For | Watch Out For |
|---|---|---|
| Cards/fobs | Employees, everyday use | Issuance, collection, and deactivation processes; legacy 125 kHz prox can be cloned |
| Mobile credentials | Remote provisioning, touchless entry | Reader compatibility, user adoption, backup access |
| PINs | Temporary or shared access | Code sharing, stale permissions |
| Biometrics/MFA | High-sensitivity areas | Privacy law and policy, exceptions, user experience |
Mobile credentials have moved quickly. HID's 2026 State of Security and Identity Report found that security, cited by 50% of respondents, has overtaken convenience (34%) as the main reason organizations adopt them.

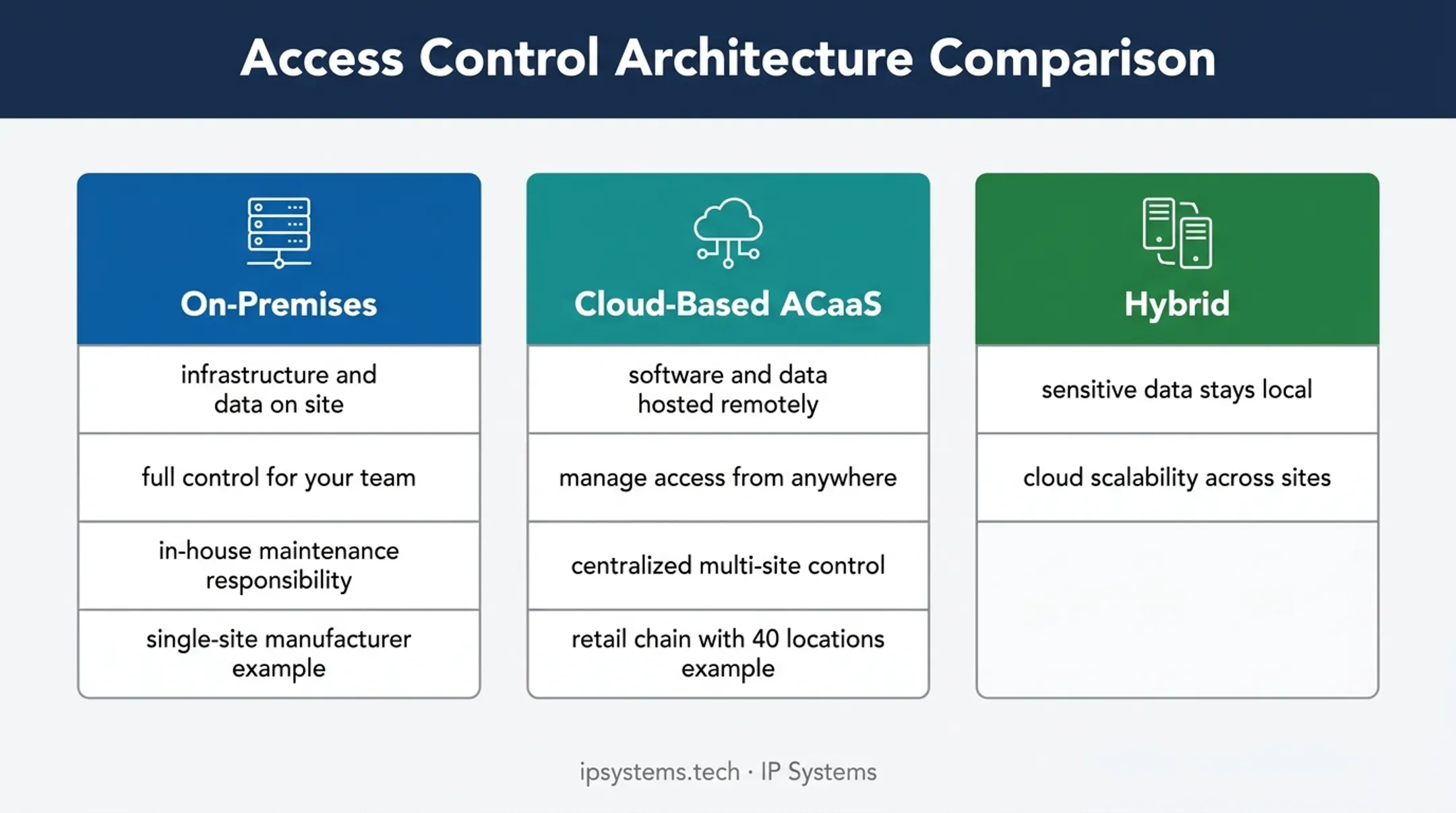

Cloud, On-Premises, or Hybrid?
- On-premises systems keep software and data on site. Your team has full control and full maintenance responsibility, including server patching
- Cloud-based (ACaaS) systems host software and data remotely, so admins can manage access from anywhere and control multiple sites centrally, usually for a recurring per-door fee
- Hybrid deployments keep door decisions and some data local while using the cloud for management across sites
None is automatically better. A single-site manufacturer with an in-house IT team might prefer on-premises. A retail chain with 40 locations and no security staff at each site usually leans cloud. When the answer isn't obvious, compare five-year cost, bandwidth at each site, and who on your staff will own updates.

Access Models and Integrations
Most commercial systems use role-based access (permissions tied to job function) or schedule-based access (permissions tied to time and day). Using both gives tighter control without constant manual overrides.
Integration matters as much as the core system. Commonly paired systems include:
- Video surveillance and video intercoms
- Visitor management
- Elevator controls
- Intrusion detection
- Fire and life-safety systems
- Building management platforms
Not every access control platform integrates with every other system. Confirm compatibility in the design phase, and ask to see the integration working, not just listed on a data sheet. There's also a trade-off here: one platform for everything is simpler to run, while best-of-breed products may do each job better but need more integration work and more vendors to coordinate.
Benefits of Commercial Building Access Control
The most immediate benefit is replacing keys. When an employee leaves, you deactivate the credential in seconds instead of rekeying doors. The same control makes it easier to change access as roles shift or contractors come and go.
Audit trails matter more than people expect. Every access event, denied attempt, and linked video clip becomes part of a record. That supports investigations and internal accountability. Organizations in regulated industries, such as healthcare and financial services, should confirm their specific obligations with legal or compliance counsel, since requirements vary by sector.
There are day-to-day gains too:
- Central administration across one or many buildings
- Scheduled lock and release without someone walking the building
- Structured visitor check-in instead of paper sign-in sheets
- Real-time visibility across multi-site portfolios
- Tighter control over restricted areas like server rooms or drug storage
The same core technology scales from a single door at a retail location to enterprise platforms managing thousands of doors. Offices, multi-tenant buildings, warehouses, manufacturing plants, healthcare facilities, schools, government buildings, financial institutions, and data centers all use variations of it.
One honest limitation: access control doesn't replace solid doors, good locks, trained staff, emergency procedures, or cybersecurity practices. It's one layer in a broader security posture, and it works only as well as it's configured and maintained.
How to Choose the Right Commercial Building Access Control System
Start with what you're protecting, not a product catalog.
Map the Site and the Risk
Walk the property. Document every door, gate, elevator, restricted room, public area, tenant space, loading dock, and remote facility. Note where valuable assets are and where an unauthorized entry would do the most damage. Then work outward from those assets in layers (deter, detect, delay, respond), and factor in past incidents and the hours the building sits empty.
Build a User and Permission Matrix
Define who needs access, where, and when:
- Employees and administrators
- Executives and sensitive-area personnel
- Contractors and vendors
- Visitors and tenants
- Delivery personnel
- Emergency responders
Check Your Infrastructure
Before choosing hardware, check:
- Door and frame condition, and lock compatibility
- Existing wiring and network capacity, including switch ports and PoE budget
- Power and backup power
- Elevator or gate interface requirements
- Cameras or legacy equipment that could be reused
A door-hardware survey is the step most often skipped. In our experience, it's also the step that causes the most change orders, because a frame or exit device that can't take the specified lock turns into a mid-project surprise. Existing equipment can be reused if it meets your needs, but confirm that in the survey rather than assuming it.
Compare Systems on Practical Criteria
Score options on the factors that affect daily use:
- Credential options and role-based permissions
- Temporary access and visitor workflows
- Cloud, on-premises, or hybrid fit
- Interoperability with video, intercom, fire, intrusion, and building systems
- Admin usability, training needs, and long-term support terms
Understand What Drives Cost
There's no single price tag for a commercial system. Door count, reader and controller hardware, lock types, credentials, hosting model, integrations, and installation complexity drive the first cost. Gallagher Security's buyer's guide adds that installation, licensing, maintenance, support contracts, software updates, and training all add up over a system's life, and that a system that looks cheap up front can cost more once you add what it needs for multi-site use. A proper proposal should itemize these rather than quote a flat number.
That itemized view is why a site assessment matters. IP Systems (IPS) has assessed, designed, and installed security systems since 1998 for organizations in healthcare, education, government, manufacturing, commercial real estate, and other industries. We plan access control together with video surveillance, fire systems, and hosted services from the start, so integrations are designed in rather than added later.
Questions to ask when comparing proposals:
- What is the door count and door schedule, and did someone survey the hardware?
- What is the credential strategy, and does it replace legacy prox?
- What network and power assumptions does the design make?
- Which integrations are included, and how will they be tested?
- Is the rollout phased or a single cutover? What's the timeline and training plan?
- What support, firmware updates, and upgrade path come after go-live?
Implementation, Management, and Maintenance
Getting the system installed is the easy part. Running it well over years takes structure.

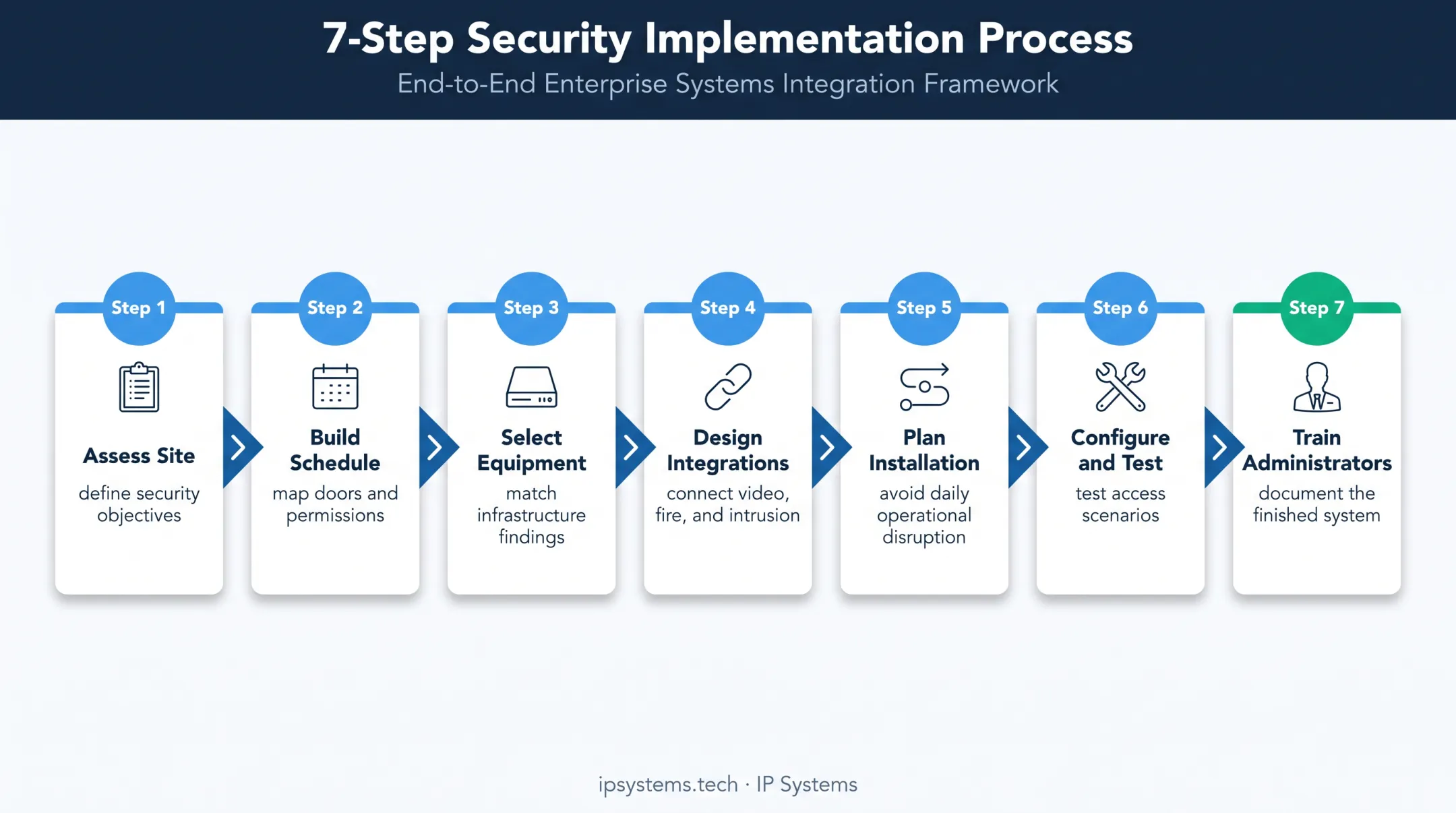

A Practical Implementation Sequence
- Assess the site and define security objectives
- Build the door and permission schedule for every user group
- Select compatible equipment based on infrastructure findings
- Design integrations with video, fire, and intrusion systems
- Plan installation phases to avoid disrupting daily operations
- Configure software and test access scenarios
- Train administrators and document the finished system

Keep the building running during rollout:
- Tell tenants and employees before work begins
- Arrange temporary access for each phase
- Keep emergency egress working throughout the install, not only after handover
- Coordinate with the fire alarm contractor and AHJ for any door tied to the fire alarm
- Schedule after-hours or shutdown-window work early; it usually carries additional cost
At closeout, don't accept the system until you've walked it: test each door, confirm fail-safe or fail-secure behavior, and get as-built drawings, the door schedule, and administrator credentials. IPS has clients accept both the installation and the training before closeout.
Ongoing Access Administration
- Onboarding new employees and offboarding departing ones
- Changing permissions when roles change
- Issuing and expiring temporary contractor and visitor access
- Handling lost credentials right away
- Running periodic access reviews to remove inactive accounts
Federal financial examination guidance calls for institutions to review access lists regularly and remove access for anyone who no longer needs it. That habit applies well beyond banking. Name one owner for the credential database. When nobody owns it, stale permissions pile up quickly.
Monitoring and Maintenance
- Review denied-entry events, forced-door alerts, and device status regularly
- Inspect readers, locks, door contacts, and backup power on a set schedule
- Apply firmware and software updates through a controlled, documented process
- Re-test integrations after any system change instead of assuming they still work
IPS's Network Operations Center provides device-health monitoring and predictive maintenance for connected security systems, checking each card access panel and server component every 60 seconds and logging how long any device was offline. When it identifies an issue, we troubleshoot and resolve it through the existing maintenance contract. IPS support programs include two preventive maintenance visits per contract year and priority response times for remote and onsite support.
Final Takeaway
Commercial building access control is a connected system. It has to be designed around your doors, users, risks, workflows, and growth plans.
The organizations that get the most from it treat installation as the starting line. After go-live, they keep it current:
- Review permissions on a set schedule
- Inspect hardware for wear and failures
- Re-test integrations when connected systems change
If you're evaluating options for a building, campus, or multi-site portfolio, IPS can walk your site, map risks and requirements, and design a system around how your organization operates. Schedule a Security Assessment to talk through design, integration, installation, and ongoing support with a team that has been doing this since 1998.
Frequently Asked Questions
How much does a building access control system cost?
Pricing depends on door count, locking hardware, readers, credentials, wiring, software licensing, integrations, and installation complexity. A site assessment produces an itemized proposal for your facility instead of a generic number.
What is the best building access control system for small businesses?
Match the platform to your door count, user volume, credential needs, existing infrastructure, and budget. Favor simple administration, dependable support, only the integrations you need, and a clear path to add doors later.
What are the top access control systems for buildings?
Strong systems combine readers, controllers, electronic locks, management software, audit logs, flexible credentials, and tested integrations with video and fire systems. No single product wins in every building; the right fit depends on your site and operations.
What is a building access control system?
It's the combination of hardware, software, credentials, and policy that decides who can enter specific areas of a building and when, and records that activity for review.
What is commercial access control?
Commercial access control governs physical entry to business facilities, such as offices, gates, elevators, and restricted rooms, for employees, contractors, visitors, and tenants. It differs from residential systems and from logical access control, which governs network access.
